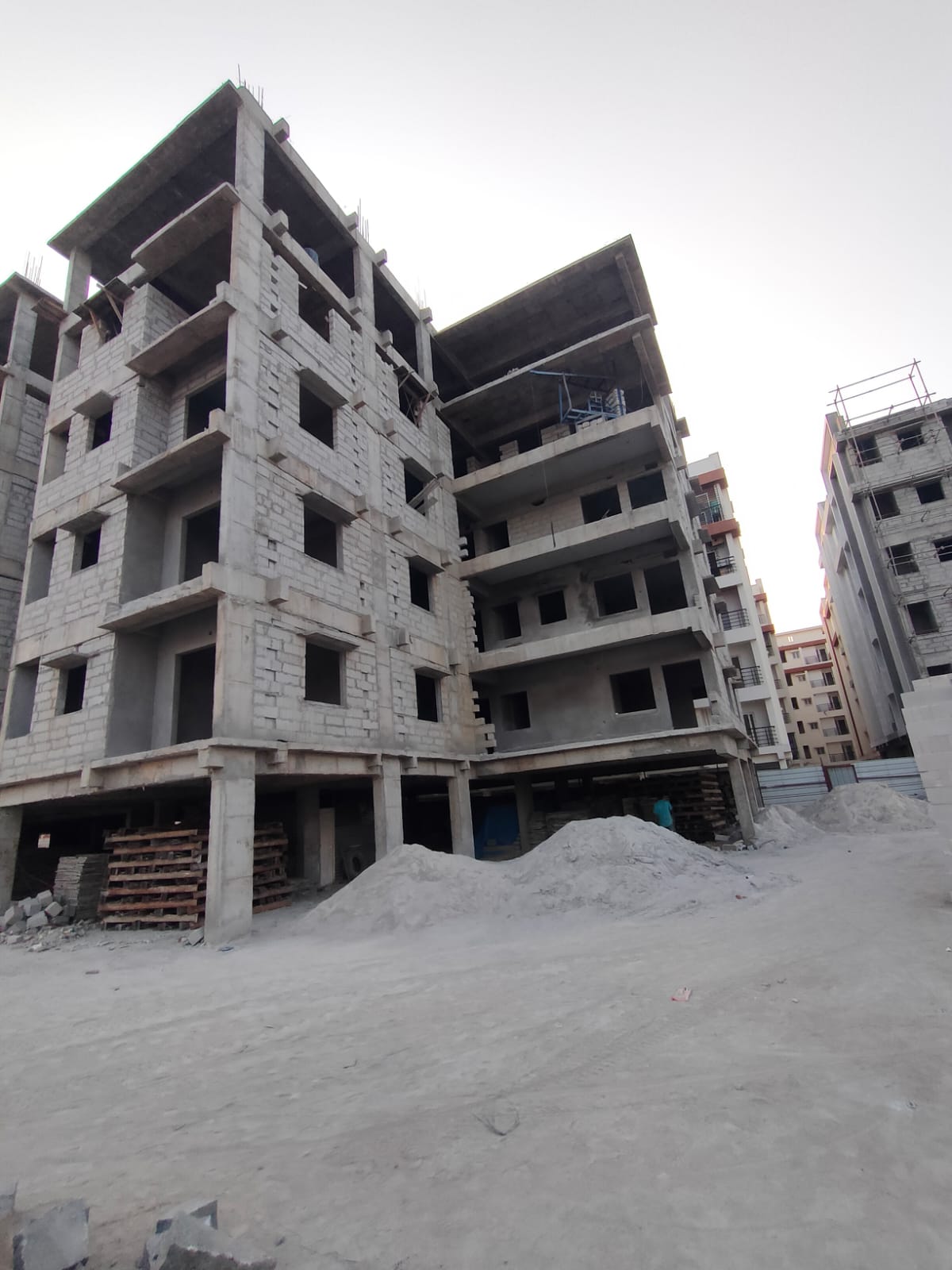

Sapphire C&D – Construction Progress Update

Date: 30th December 2025

Article by ROSE

Sapphire – D Block

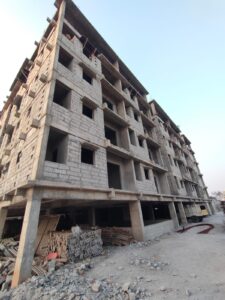

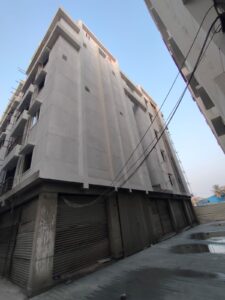

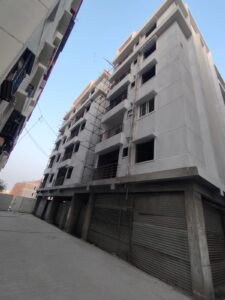

Internal plastering has been completed. External plastering is completed on three sides, with primer application completed on two sides. CPVC plumbing work has been completed in all flats. Waterproofing work is currently in progress.

Sapphire – D Block

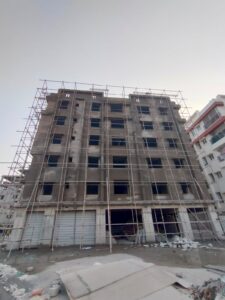

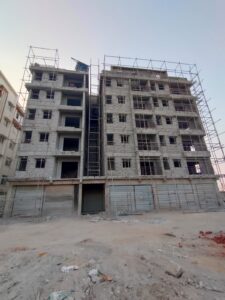

The 5th-floor slab has been completed. Internal plastering and brickwork on the 3rd floor are completed. Brickwork on the 4th floor is currently in progress.
